Project Background

Abstract

This project analyzes the various drainage factors that could affect the transmittal of stormwater going through the culverts at the intersection of Steves Blvd and the Fanning Wash. An analysis was needed at this intersection due to clogging of the culverts, as well as sedimentation being found at the inlet of the three culverts. Through this analysis the existing conditions will be analyzed for the channel and culverts by also looking at upstream and downstream conditions to produce an accurate model of the flow path. The analysis will determine the runoff based off of different storm events, and predict where flooding could occur within our project limits. Proposed modeling will guide the recommendations to improve the existing drainage conditions where modifications will be made on the channels and culverts to determine if these modifications will help or hurt the existing channel or culvert. Considerations will be made for the downstream conditions to show how the proposed conditions at the intersection will affect the stormwater flow upstream and downstream of our project area. All existing and proposed designs will be produced using the City of Flagstaff Stormwater Design Manual. The sections below explain the work scope, project constraints,  proposed schedule of design work, and the cost of engineering services.

Project Location

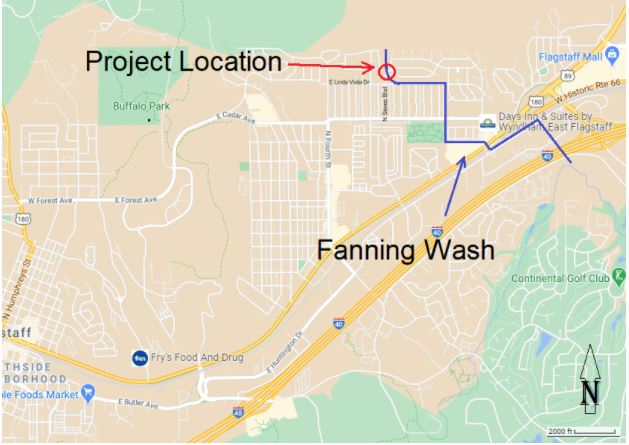

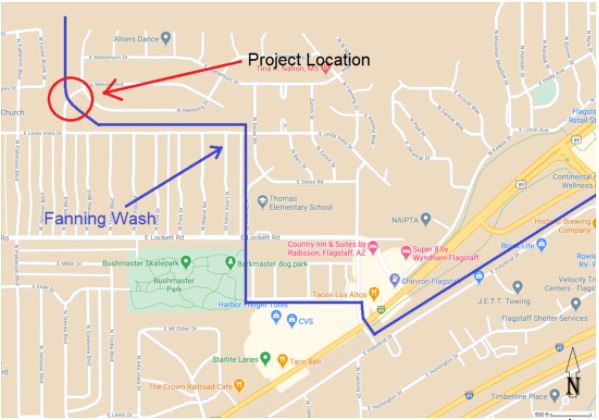

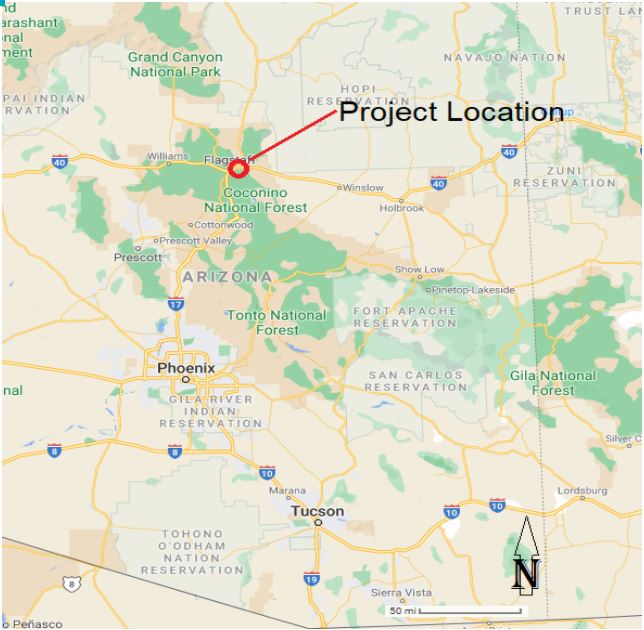

The three figures depicted below show the project location and extents of the Fanning Wash at the intersection of Steves Blvd.

Overview of Site Photo Credits: Google Maps

Zoomed in Location of Site Photo Credits: Google Maps

Site Location within Flagstaff Photo Credits: Google Maps

Project Tasks

The project work scope included seven major tasks listed below:

Task 1: Site Investigation

  Task 1.1: Field Visit and Initial Assessment of the Intersection

  Task 1.2: Field Surveying

  Task 1.3: Documentation of Existing Structures/Topography

  Task 1.4: Review Existing Approved Plans

  Task 1.5: FEMA Floodplain Information

Task 2: Hydrologic Analysis

  Task 2.1: Analyze Previous Precipitation Data

  Task 2.2: Watershed Delineation

  Task 2.3: Determine Natural Runoff

  Task 3: Hydraulic Analysis

  Task 3.1: Analyze Previous Drainage Studies

  Task 3.2: Determine Existing Channel and Culvert Capacity

  Task 3.3: Design Recommended Channel and Culvert Modifications

Task 4: Construction Plans

  Task 4.1: Existing Floodplain Map

  Task 4.2: Existing Topographic Survey with Culverts

  Task 4.3: Existing Channel Plan and Profile

  Task 4.4: Proposed Channel Plan and Profile

  Task 4.5: Existing and Proposed Channel Cross Sections

  Task 4.6: Channel Design Details

  Task 4.7: Culvert Design Details

  Task 4.8: Erosion Protection Design

  Task 4.9: Project Notes and Specifications

  Task 4.10: General Project Details

Task 5: Evaluate Project Impacts

  Task 5.1: Environmental Impacts

  Task 5.2: Societal Impacts

  Task 5.3: Economic Impacts

Task 6: 30%, 60%, 90% and Final Deliverables

Task 7: Project Management

  Task 7.1: Project Meetings

  Task 7.2: Schedule Management

  Task 7.3: Resource Management

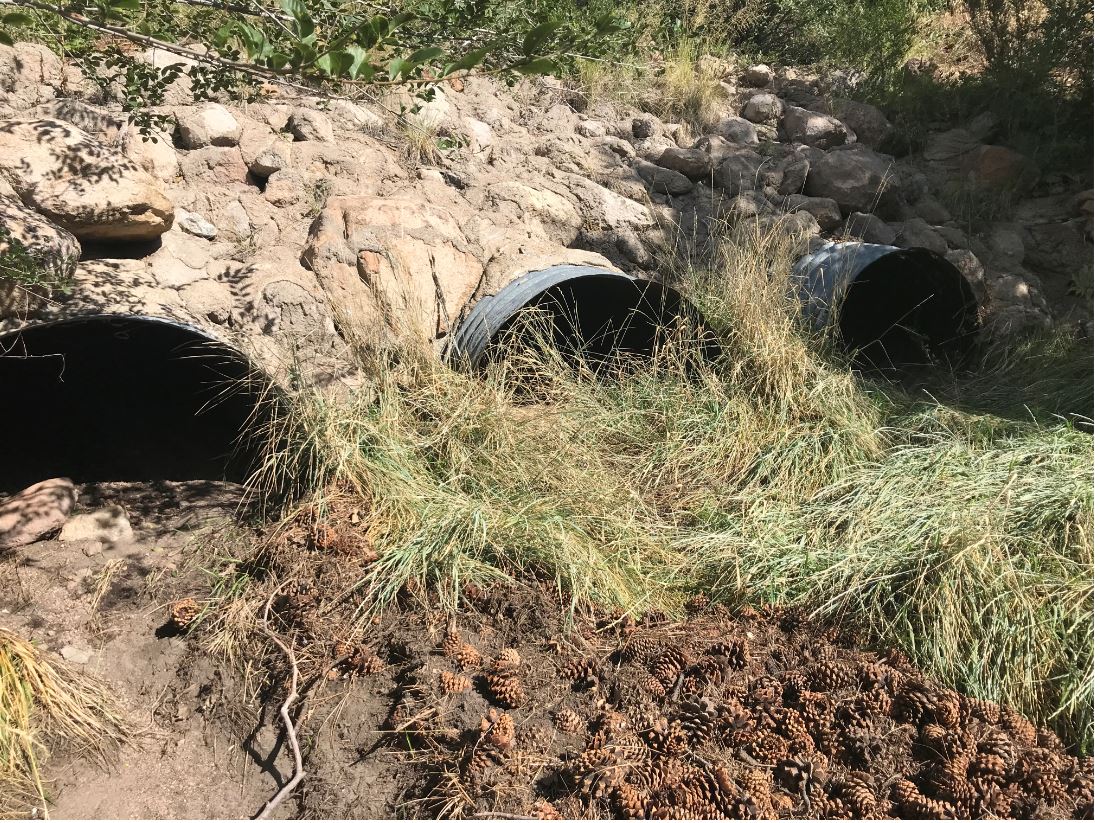

Existing Outlet Culvert Locations at the Intersection Photo Credits: Cole Kelley

Project Constraints

The four primary project constraints are shown below:

Surveying of Private Property: land boundary surveys, property corners, and drainage easements

Geotechnical Engineering: subsurface hydrology, soil properties through various testing, and compaction

Traffic Analysis: traffic flows, and roadway speed limit

Roadway Analysis: pavement design, roadway width, and other roadway geometric conditions

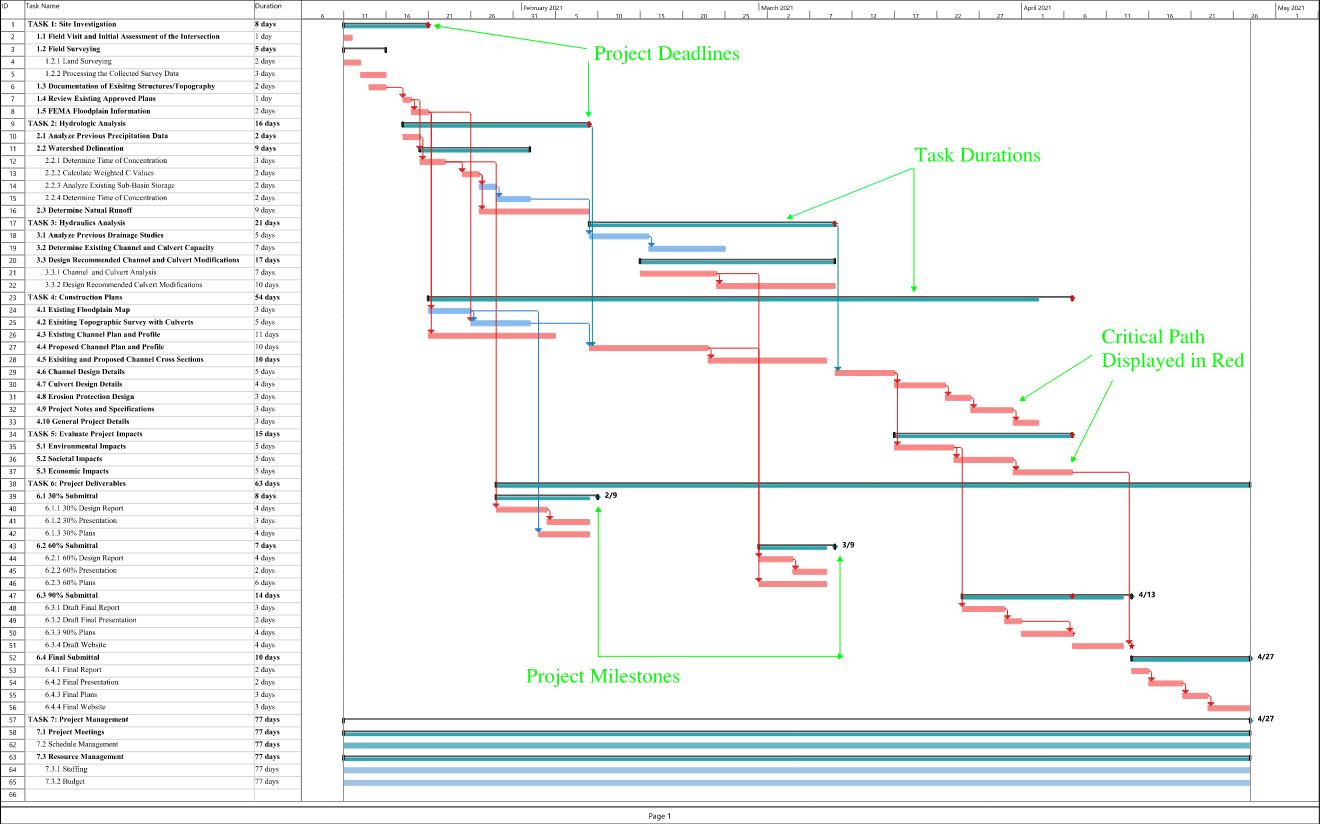

Project Schedule-Gantt Chart

A Gantt Chart was produced to show when the necessary project task will be completed, to comply with deadlines set out by the course. Milestones were identified to ensure the project stayed on track with the schedule. The critical path for our design is displayed below in red.

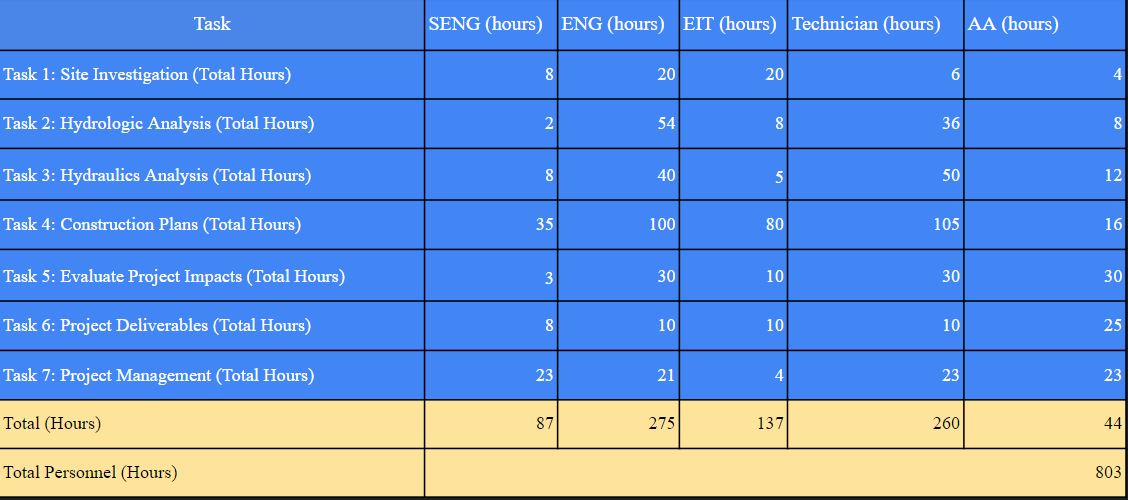

Project Staffing

The design team plans to spend a total of 795 hours on the project to complete all of the major tasks shown above. The table below depicts the estimate for the engineering design services.

Project Costs

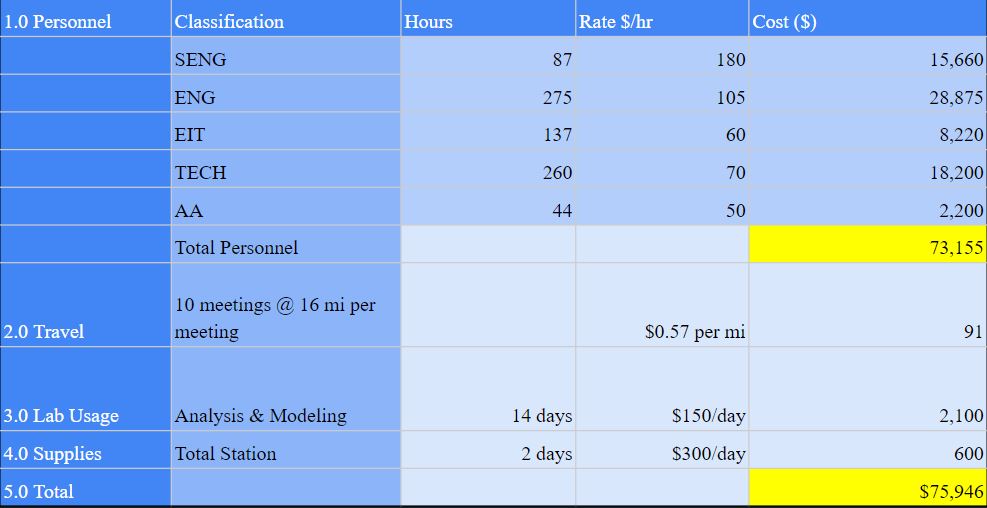

The project was projected to cost about $76,000 for all aspects of the design which included personnel, travel, supplies and licenses for the different softwares needed for analysis.
