Corn Cob Biosorbent Research

Home | Project Info | Documents | Findings

Project Information

General information about this research project can be found here. Included on this page are the background to how this research began, the project tasks that were completed for this capstone project, the scheduling of the different tasks, the staffing plans to complete the tasks, and the project budget.

Project Background

Melissa Jacquez began researching the potential for corn cobs to remove cadmium from drinking water in Fall 2017 and Spring 2018. She received funding as an intern under the NASA Space Grant Program, where she conducted cadmium testing and produced a preliminary isotherm (background research photos). While the preliminary results looked promising, there was insufficient amount of concentrations and inconclusive data. To continue this research, Melissa's project was created into a capstone project.

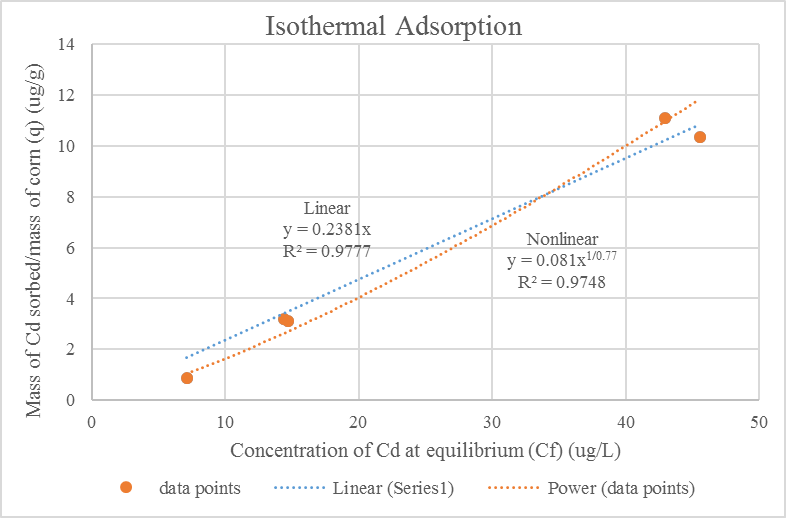

preliminary isotherm

Figure - preliminary isotherm produced from Melissa's initial research

Project Task List

Here is a list of the major tasks for our project. To see the subtasks within each major task, see the project schedule or staffing plan below.

  • Task 1 - Experimental Methods
  • Task 2 - Isotherm Development
  • Task 3 - Prototype Design
  • Task 4 - Pilot Testing & Scale-up
  • Task 5 - Cost Benefit Analysis
  • Task 6 - Project Management

Schedule

Our project schedule and Gantt charts can be found here. Some tasks are dependent on the previous task being completed, while others can be started simultaneously. Our team developed a schedule during the proposal phase, and adjustments were made during the course of the project. In total, the project is going to last 197 days. Below, the original and updated Gantt chart can be found.

old gantt chart

Figure (above) - Old Gantt chart (critical path is highlighted)

After experiencing set-backs during the course of the project, some tasks were eliminated. The first major set-back was the breaking of the team's only separatory funnel. Our team expected to wait only one week for a new one to ship and arrive at NAU's environmental lab; however, we ended up waiting three weeks. The next major set-back was disocvering that the cuvette samples that are analyzed for cadmium concentrations were light-sensitive and the absorbance (correlated to the concentration) decreased over time. Our team needed to account for this because it gave us far greater removal efficiencies. Finally, our team discovered that our original prediction for the time needed to complete lab testing was very inaccurate. We expected to spend 3 hours to complete any given concentration during our testing (3 replicates for each). We discovered it took twice as long, or 6 hours on any given lab day. Due to these reasons, our team eliminated lead testing from our project. Below, shows the updated Gantt chart for the project schedule.

gantt chart

Figure (above) - updated Gantt chart (critical path shown in red)

Staffing Plan

Our project consists of three different roles; a senior engineer, a project engineer, and a lab technician. Below, is the proposed staffing plan that our team initially expected to spend on this project. In total, 625 hours were estimated to complete this project.

Table 1 - Proposed staffing plan

Task

SENG Hours

ENG Hours

LAB Hours

Total

Task 1.0 Experimental Methods

 0

190

190

Task 1.1 Corn Biosorbent Preparation

36

36

Task 1.2 Cadmium Testing

71

71

Task 1.3 Lead Testing

83

83

Task 2.0 Isotherm Development

1

11

0

12

Task 3.0 Prototype Design

8

14

0

22

Task 3.1 Design Calculations

1

9

10

Task 3.2 Construction Drawings

1

5

6

Task 3.3 Construction

6

6

Task 4.0 Pilot Testing and Scale-up

2

12

109

123

Task 5.0 Cost Benefit Analysis

1

11

0

12

Task 5.1 Feasibility Assessment

0.5

5.5

6

Task 5.2 Assessment of Benefits

0.5

5.5

6

Task 6.0 – Project Management

113

153

0

266

     Task 6.1 Professional/Team                Interactions

108

108

     Task 6.2 Project Deliverables

79

79

     Task 6.2.1 30% Report

16

16

     Task 6.2.2 60% Report

20

20

     Task 6.2.3 Final Report

5

10

15

     Task 6.2.4 Website

20

20

     Task 6.2.5 Final Presentation

8

8

TOTAL

125

201

299

625

Due to unexpected complications during lab testing, more hours needed to be spent to ensure the best quality of data possible. Below, is the finalized staffing plan for this research project.

Table 2 - actual staffing plan

Task

SENG Hours

ENG Hours

LAB Hours

Task total

Task 1.0 Experimental Methods

0

18

308.5

326.5

Task 1.1 Corn Biosorbent Preparation

0

10

103

113

Task 1.2 Cadmium Testing

0

8

205.5

213.5

Task 2.0 Isotherm Development

0

7

0

7

Task 3.0 Prototype Design

0.5

72.5

8

81

Task 4.0 Pilot Testing and Scale-up

0

34.5

11.5

39

Task 5.0 Cost Benefit Analysis

2

21.5

0

23.5

Task 5.1 Feasibility Assessment

0

13.5

0

13.5

Task 5.2 Assessment of Benefits

2

8

0

10

Task 6.0 Project Management

153

147

0

325

     Task 6.1 Professional/Team           Interactions

91

32.5

0

128

     Task 6.2 Project Deliverables

62

114.5

0

197

     Task 6.2.1 30%

30.5

2.5

0

33

     Task 6.2.2 60%

23.5

9

0

32.5

     Task 6.2.3 Final Report

1.5

39.5

0

41

     Task 6.2.4 Website

0

36

0

36

     Task 6.2.5 Presentation

6.5

27.5

0

54.5

TOTAL

180.5

300

328

809

Project Budget

Based off the staffing plans shown above, the proposed budget and the actual budget are shown below.

Table 3 - proposed budget

Personnel

Classification

Hours

Rate, $/hr

Cost

SENG

125

120

$15,000

ENG

201

90

$18,090

LAB

299

55

$16,445

Total

$49,535

Supplies

Item

Quantity

Cost Each

Cost Total

Syringe Pump

1

300

$300

Cadmium Reagents

56

6.80

$381

Lead Reagents

63

7.52

$474

Acrylic Plexiglass (2'x6')

1

14

$14

Corn Cobs

60

1

$60

Ninja Food Processor

1

20

$20

PPE

4

90

$360

Lab Rental Fee

45 days

286/day

$12,870

Total

$14,479

Subcontracting

Subcontractor

Cost

Engineering Fabrication Shop

$50.00

Total

$50.00

Project Total

$64,064

Table 4 - actual budget; $17,537 over

Personnel

Classification

Hours

Rate, $/hr

Cost

SENG

180.5

120

$21,660

ENG

300.5

90

$27,045

LAB

328

55

$18,040

Total

$66,745

Supplies

Item

Quantity

Cost Each

Cost Total

Peristaltic Pump

1

1,720

$1,720

Cadmium Reagents

36

6.8

 $245

Adsorption column

1

46.4

$46

Corn Cobs

60

1

$60

Ninja Food Processor

2

20

$40

PPE

4

90

$360

Lab Rental Fee

41

286/day

 $11,726

Total

$14,197

Subcontracting

Subcontractor

Cost

Western Technologies Inc.

$659

Total

$659

Project Total

$ 81,601
