Grand Canyon Railway
Boiler Wastewater Treatment & Storage

Main Content

TASKS

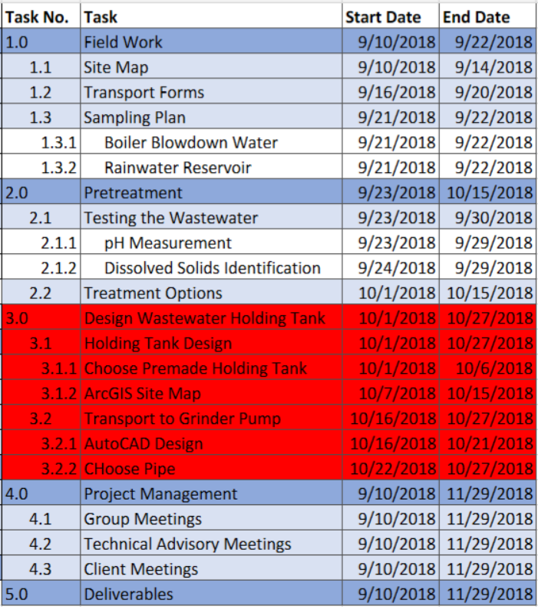

The image on the right displays the proposed project tasks and associated schedule. Some changes were made from the proposed schedule due to new client information and testing limitations. These removed tasks are shown in red. The pipe network deign to transport wasterwater to the onsite grinder pump was removed as the GCR has transportable pipes that can be used when needed. The storage tank design was removed as each option would require a different storage tank, and so that task was absorbed into the treatment options.

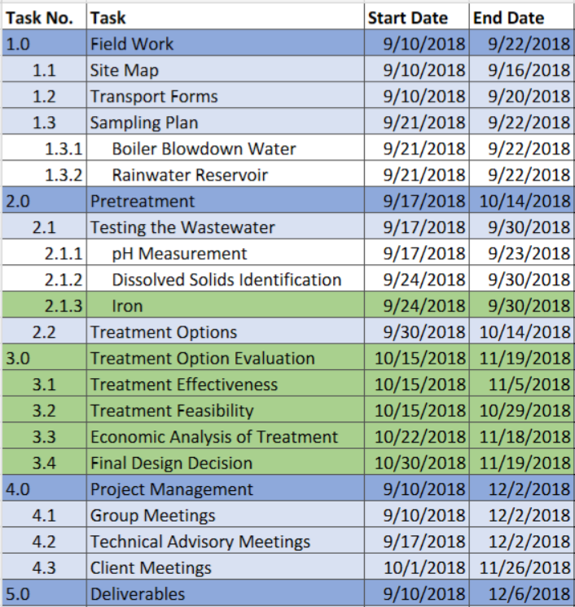

The actual tasks and task schedule is shown on the right. The tasks highlighted in green display the added tasks. Some wastewater testing was meant to be done at an analytics lab, however this was not able to be done, so more in-house testing was added. Treatment option evaulation was added to ensure the best, feasible design that meets the client's criteria.
