Verde Valley Water Treatment
Project Details
Project Management
Positions:
SENG |
ENG |
LAB |
INT |
AA |
Senior Engineer |
Engineer |
Lab Aide |
Intern |
Administrative Assistant |
Hours per Position:

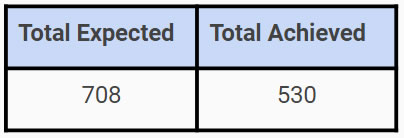

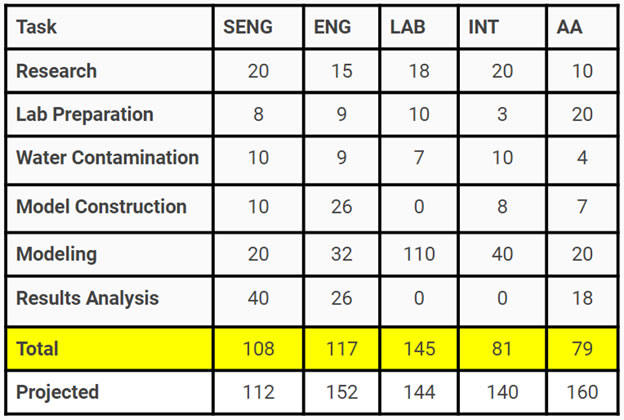

Hours per task per each position. Highlight row shows the hours the team reached with the hours the team projected at the bottom. These hours are totaled in the table below.

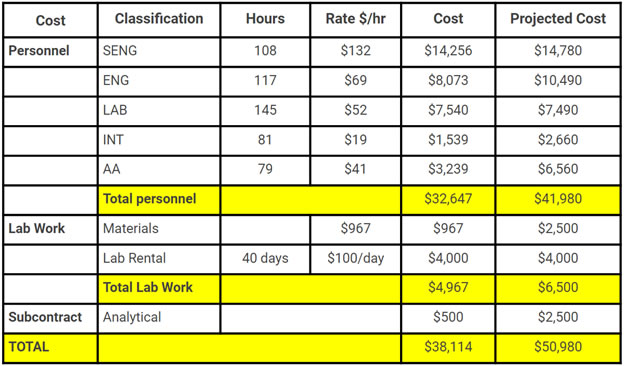

Budget
Project cost broken down by personal hours, the lab work, and the subcontract. The team projected costs for each of the items as seen in the column farthest to the right. The actual cost can be seen in the "Cost" column to the right of the "Projected Cost" column. As seen in the "Total" row highlighted at the bottom the difference between the actual and projected costs can be seen, respectively. This project came under budget by about $13,000.
