Project Timeline

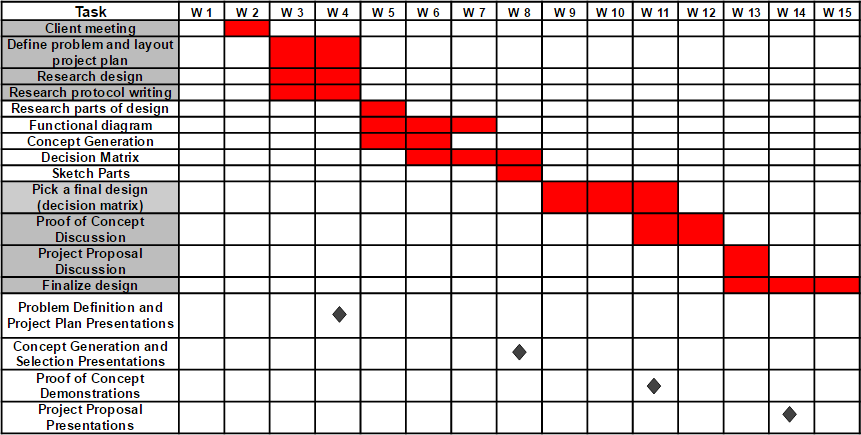

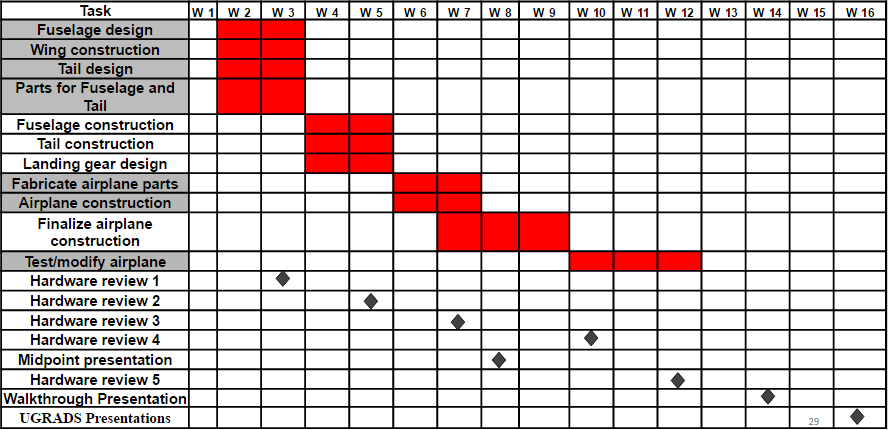

The project timeline is for the SAE Aero capstone team is outlined in a Gantt chart pictured below. The first 15 weeks signifies work done throughout the first semester of mechanical engineering capstone design. This includes the problem definition, project plan, concept generation, and design. The second 15 weeks signifies work done throughough the second semester of mechanical engineering capstone design. This includes design and construction.
