Project Description

The purpose of this project is to evaluate and improve user safety at two of Flagstaff's major intersections: S Milton Rd/W University Ave and S Milton Rd/Route 66. These intersections were selected using the Arizona Department of Transportation (ADOT) network screening which determined the intersections as "hotspots" due to the high-risk of crashes at those locations. A frequency of incidents involving road users and pedestrians indicate additional safety measures are required at both intersections. Practical solutions and improvements were identified to reduce the risk of incidents while maintaining efficiency at both intersections.

Project Location

Project Constraints

Project Tasks

Gantt Chart

Project Staffing

Cost of
Engineering Services

Project Location

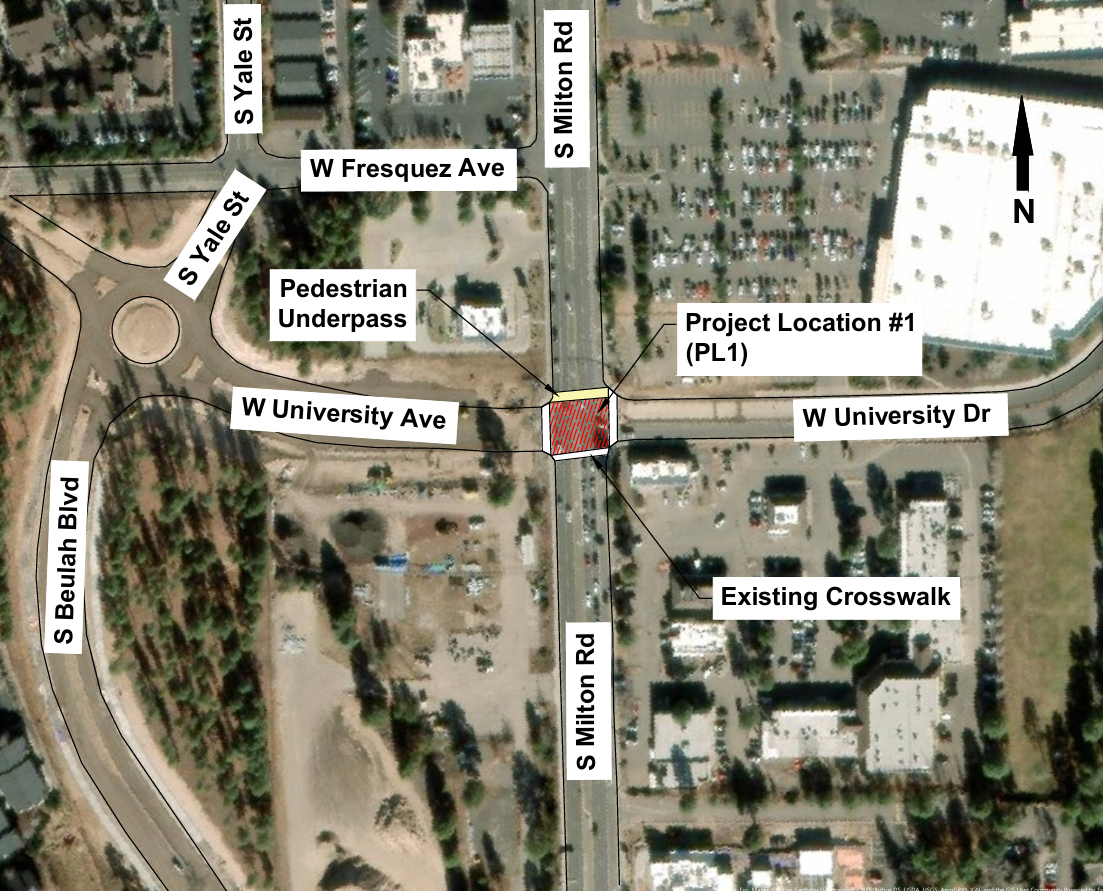

Project Location #1 is located at the intersection of S Milton Rd and W University Ave in Flagstaff, Arizona.​ The intersection currently has three existing crosswalks with a pedestrian underpass.

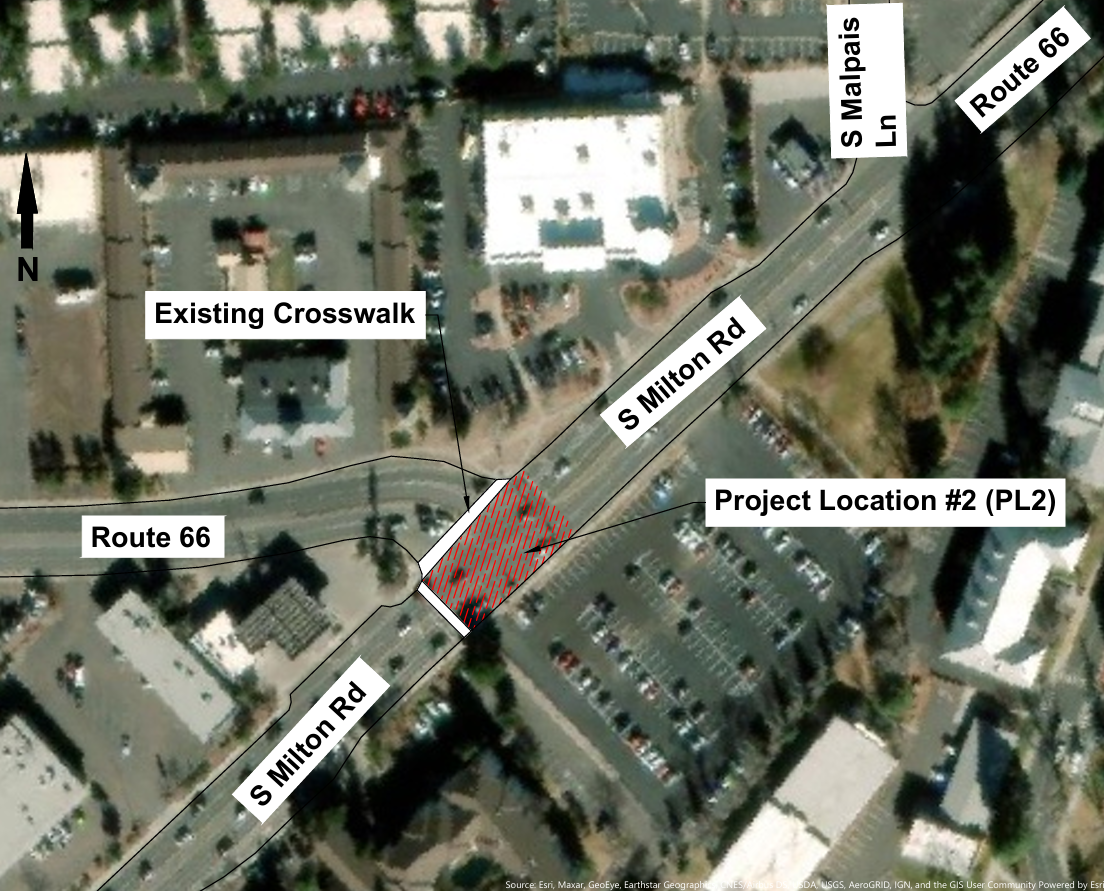

Project Location #2 is located at the intersection of S Milton Rd and Route 66 in Flagstaff, Arizona. There are currently two existing crosswalks in the intersection. ​

Back To Top

Project Constraints

Schedule

Regulations and Standards

This project is being completed in Flagstaff, Arizona which is under the jurisdictions of the ADOT, City of Flagstaff, and FHWA agencies. These agencies each have their own specified regulations which our team needs to follow in order to complete the project within regulations.

The timeframe to complete this project is not unlimited and there are multiple project deliverable deadlines which the team needs to meet. This creates scheduling constraints and forces the team to operate efficiently and without setbacks when working on the project.

Intersection Geometry

Both of our project intersections are pre-existing developments which cannot be easily changed. This forces us to generate alternatives which improve the already in place geometry, while maintaining safety and efficiency for all road users.

Back To Top

Project Tasks

Back To Top

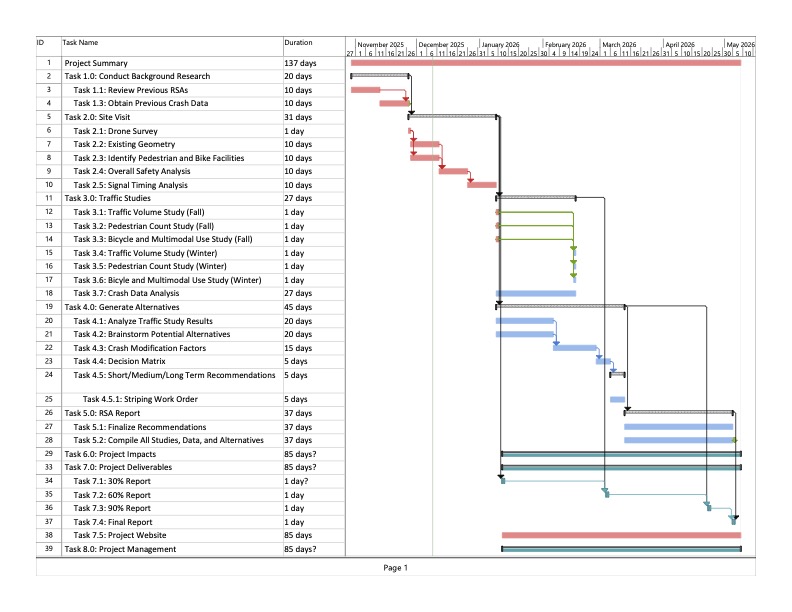

Gantt Chart

The total duration of the project will be 191 days based on a 5-day work week schedule. The starting date is set to be 10/30/2025. The ending date of the project is expected to be 05/08/2025.

Back To Top

Project Staffing

Staffing Matrix

This project has an estimated
 total of 606 hours to complete every task and subtask listed. The senior engineer and project
 manager will oversee most tasks and support the team when needed. The traffic and roadway engineers will complete most
of the technical content of this project, while the Engineer in training will support the TE and RE
while also helping develop the project deliverable documents. Overall, the majority of the project hours are split
between the roadway engineer and traffic engineer. The Project manager and senior engineer have more hours in project management and overseeing technical tasks. The EIT will support the other team members in most tasks and will be present for all field studies and team meetings.

Back To Top

Cost of Engineering Services

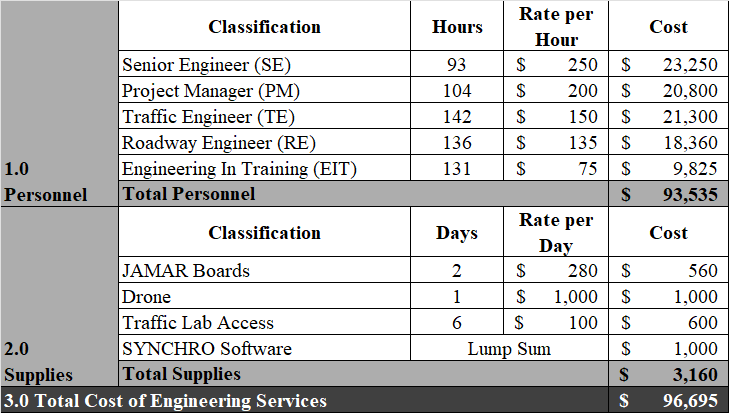

The cost of engineering services below demonstrates the cost of the specified sections of the project along with their respective cost. Personnel along with supplies and equipment is taken into consideration for the total cost.

Back To Top
