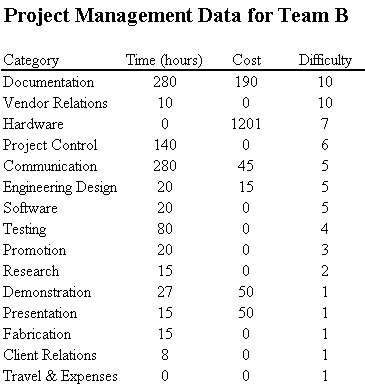

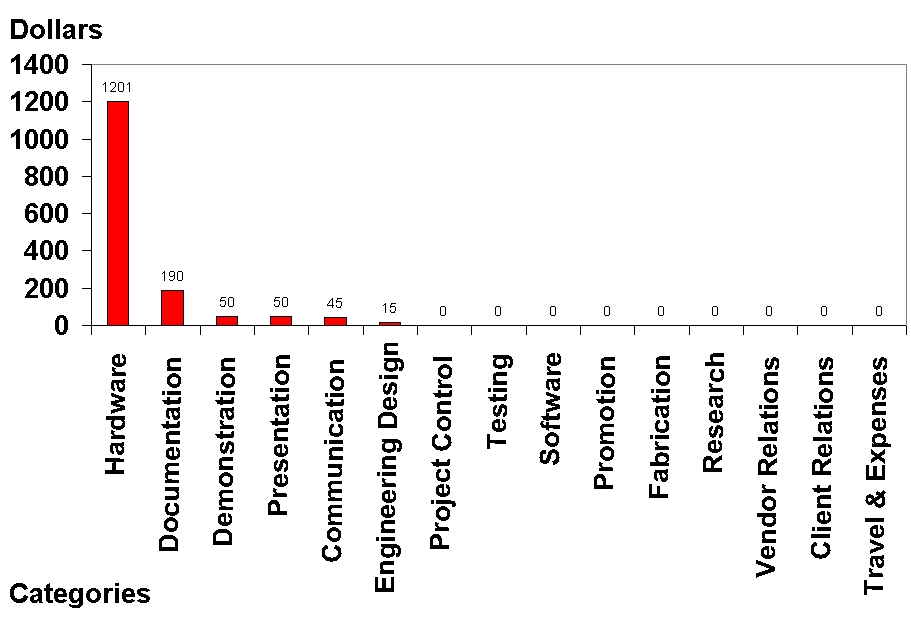

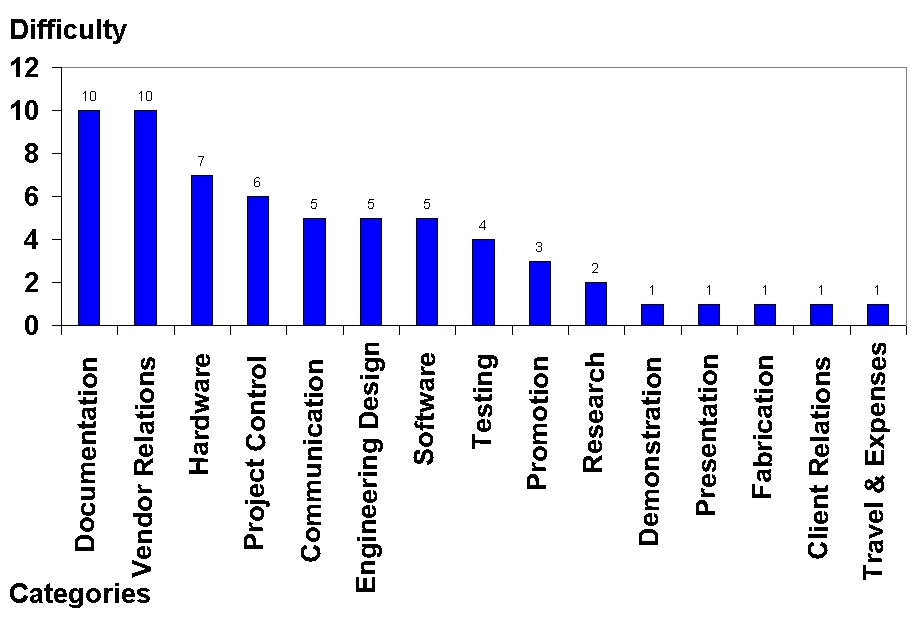

Over the course of the Emergency Dialer Project, the IHD Team has tracked the cost, time spent, and degree of difficulty in several categories in order to analyze the overall project management. The following spreadsheet and charts detail the IHD Team’s activities in the development of the Emergency Dialer System.
